News

Industrial Burner Installation and Commissioning for a Rock Wool Plant in Moscow

August 5, 2026
By kenny
50 min read
kenny
kenny

Kenny, a Shanghai Yankong expert, delivers turnkey combustion solutions globally, bridging the gap between engineering and operations to maximize safety and ROI for industrial clients.

Article Cover
TL;DR: Heatflam completed the installation and commissioning of five Baltur gas burners for a rock wool manufacturing plant in Moscow, Russia: four TBG 80 LX P units and one TBG 200 LX P unit. The site work covered wiring verification, ignition and high-fire adjustment, abnormal-noise troubleshooting, ignition-assembly training, remote-signal integration, and an air-pressure-switch relay modification. Repeated start-stop and operating tests produced stable ignition, stable low-fire temperature control without overshoot, high-fire operation at the required set temperature, and normal remote start, stop, alarm-reset, and temperature-setting signals.

Industrial burner commissioning is the point at which installed equipment, field wiring, combustion settings, safety interlocks, and plant controls must work as one system. At a rock wool manufacturing plant in Moscow, Heatflam supported the installation and commissioning of a five-burner package and verified its operation under actual site conditions.

This project case study explains the equipment configuration, the on-site work completed, the operating issues addressed, the test methods used, and the final observed results. It also shows why burner installation and commissioning requires more than starting each burner individually: wiring, ignition positions, high-fire settings, pressure-switch logic, remote commands, and operator procedures all have to be checked together.

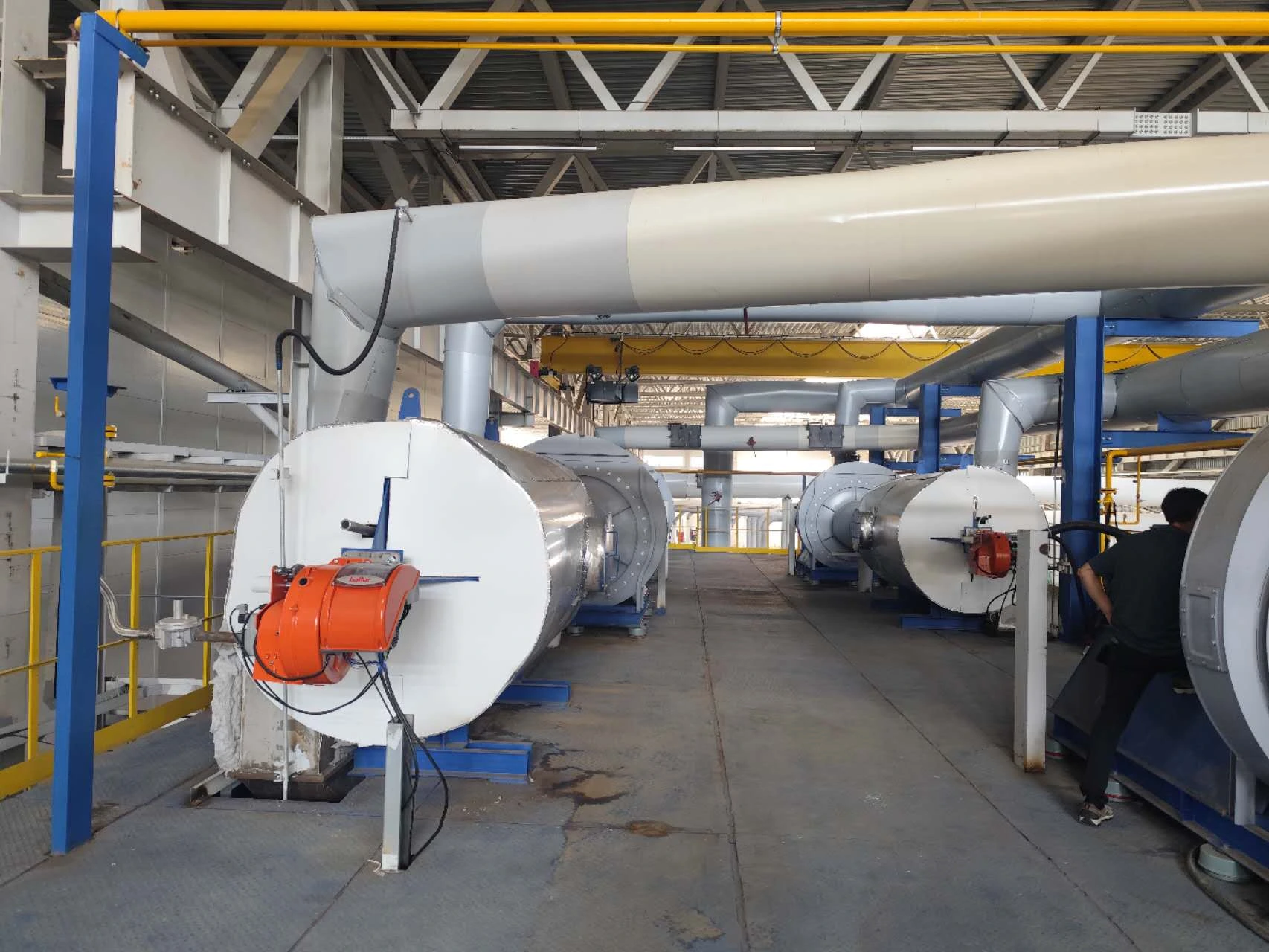

Rock wool production line and industrial heating equipment at the Moscow project site
Rock wool production equipment and the surrounding industrial installation at the Moscow project site.

Project Overview and Equipment Configuration

The application was a burner system for a rock wool manufacturing plant in Moscow, Russia. The installed configuration consisted of:

  • Four Baltur TBG 80 LX P burners
  • One Baltur TBG 200 LX P burner

Baltur’s model-specific sales sheets identify both TBG 80 LX P and TBG 200 LX P as two-stage gas burners. In this project, staged operation made correct ignition-position and high-fire-position adjustment central to the commissioning scope. Model selection and project suitability remain dependent on the required heat output, fuel and gas-train conditions, furnace interface, voltage, process temperature, control philosophy, and site environment.

Burner Specifications

According to Baltur’s April 2025 English sales sheets, both models are two-stage gas burners designed for staged heat delivery. The technical data below provides the output range, electrical requirements, motor rating, emissions class, and natural-gas reference condition for each model. See the official TBG 80 LX P data sheet [1] and TBG 200 LX P data sheet [2].

Model / Quantity Fuel and Operation Rated Thermal Output 50 Hz Electrical Data Technical Reference
TBG 80 LX P / 4 units
Part no. 18490010
Gas burner; two-stage operation. Published data use natural gas at Hi = 35.80 MJ/m³ (0°C, 1013 mbar) as the reference condition. 120–800 kW
EN 676 emissions class 3
3N AC, 50 Hz, 400 V
1.1 kW motor
Baltur sales sheet [1]
TBG 200 LX P / 1 unit
Part no. 18760010
Gas burner; two-stage operation. Published data use natural gas at Hi = 35.80 MJ/m³ (0°C, 1013 mbar) as the reference condition. 200–1,900 kW
EN 676 emissions class 3
3N AC, 50 Hz, 400 V
3.0 kW motor
Baltur sales sheet [2]
Project Item Verified Project Information
Location Moscow, Russia
Application Rock wool manufacturing plant burner system
Burner configuration 4 × Baltur TBG 80 LX P; 1 × Baltur TBG 200 LX P
Commissioning scope Wiring, start-up, staged-position adjustment, troubleshooting, training, remote control integration, and relay-circuit modification
Operating verification Repeated start-stop tests, low-fire temperature-control observation, high-fire setpoint verification, and remote-signal function checks

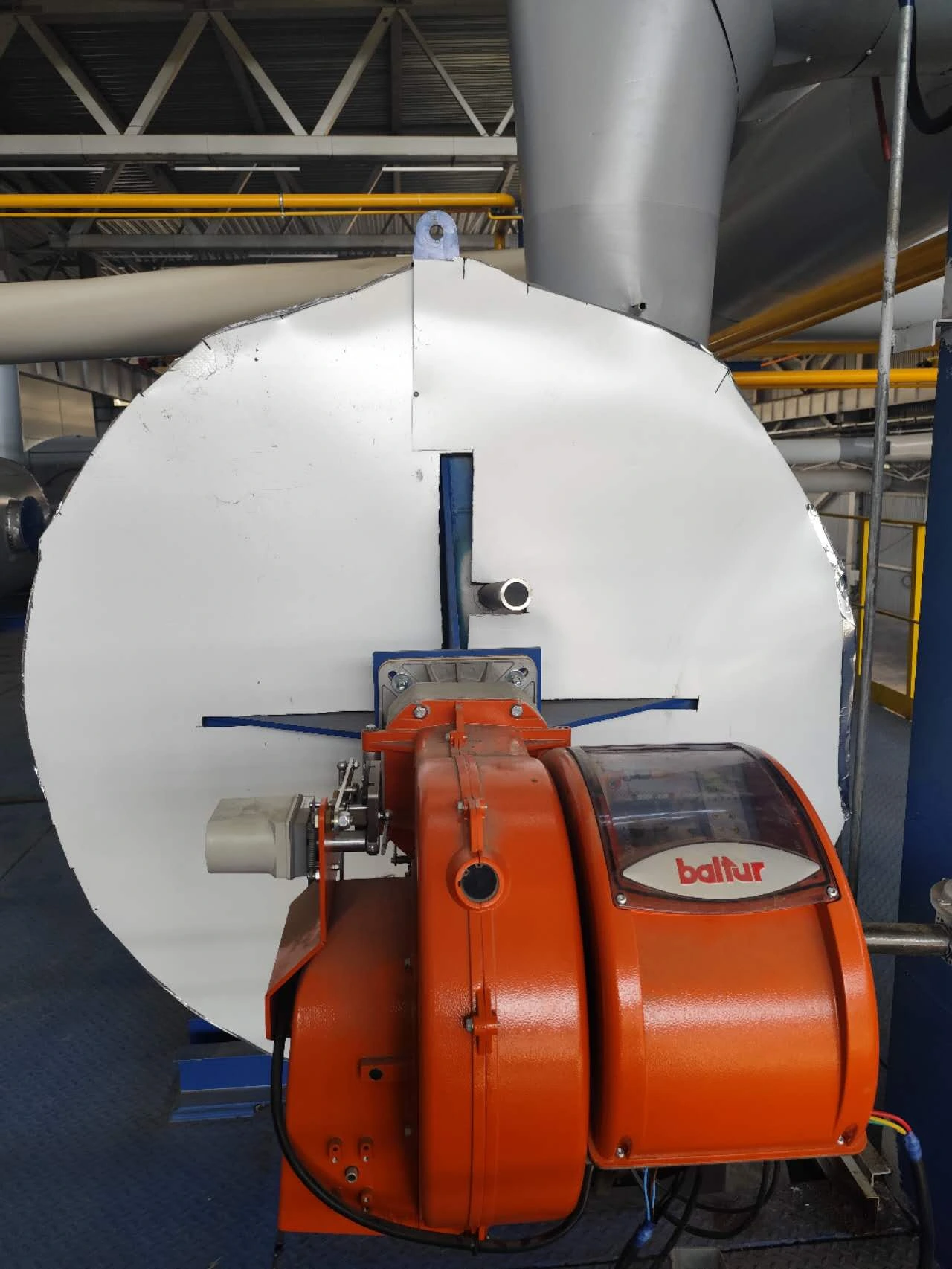

Close view of an orange Baltur burner installed at the Moscow rock wool plant
Close view of a Baltur burner installed as part of the five-burner project configuration.

What On-Site Burner Installation and Commissioning Work Was Completed?

1. Field Wiring and Cable-Number Verification

Before start-up, the field wiring was checked against the assigned cable numbers. This step helped confirm that the installed connections corresponded to the intended burner and control functions. For a multi-burner installation, systematic line-number verification reduces the risk of testing the correct command against the wrong field circuit.

2. Start-Up Testing and Ignition-Position Adjustment

Each burner was started under controlled site conditions. The ignition position was adjusted to support repeatable light-off during subsequent start-stop trials. This was not treated as a single successful ignition event; the team used repeated operation to determine whether the setting remained stable.

3. High-Fire Position Setting

After the ignition stage was established, the high-fire position was set and checked against the plant’s required operating temperature. The purpose of this step was to confirm that the burner system could move from its lower operating stage to the required high-fire condition and raise the process to the specified temperature.

4. Investigation of Abnormal Operating Noise

Abnormal noise was identified during operation and addressed as part of the industrial burner troubleshooting scope. The issue was handled together with the staged burner adjustment rather than as an isolated acoustic symptom. This approach matters because operating noise can be influenced by the relationship among burner settings, airflow, mechanical installation, and actual furnace conditions.

5. Ignition-Assembly Service Training

On-site operators and maintenance personnel were trained on the removal and reinstallation of the ignition assembly. The procedure was demonstrated beside the installed burner so the training reflected the available access space and the actual equipment arrangement. This gives maintenance teams a practical reference for future inspection and service work.

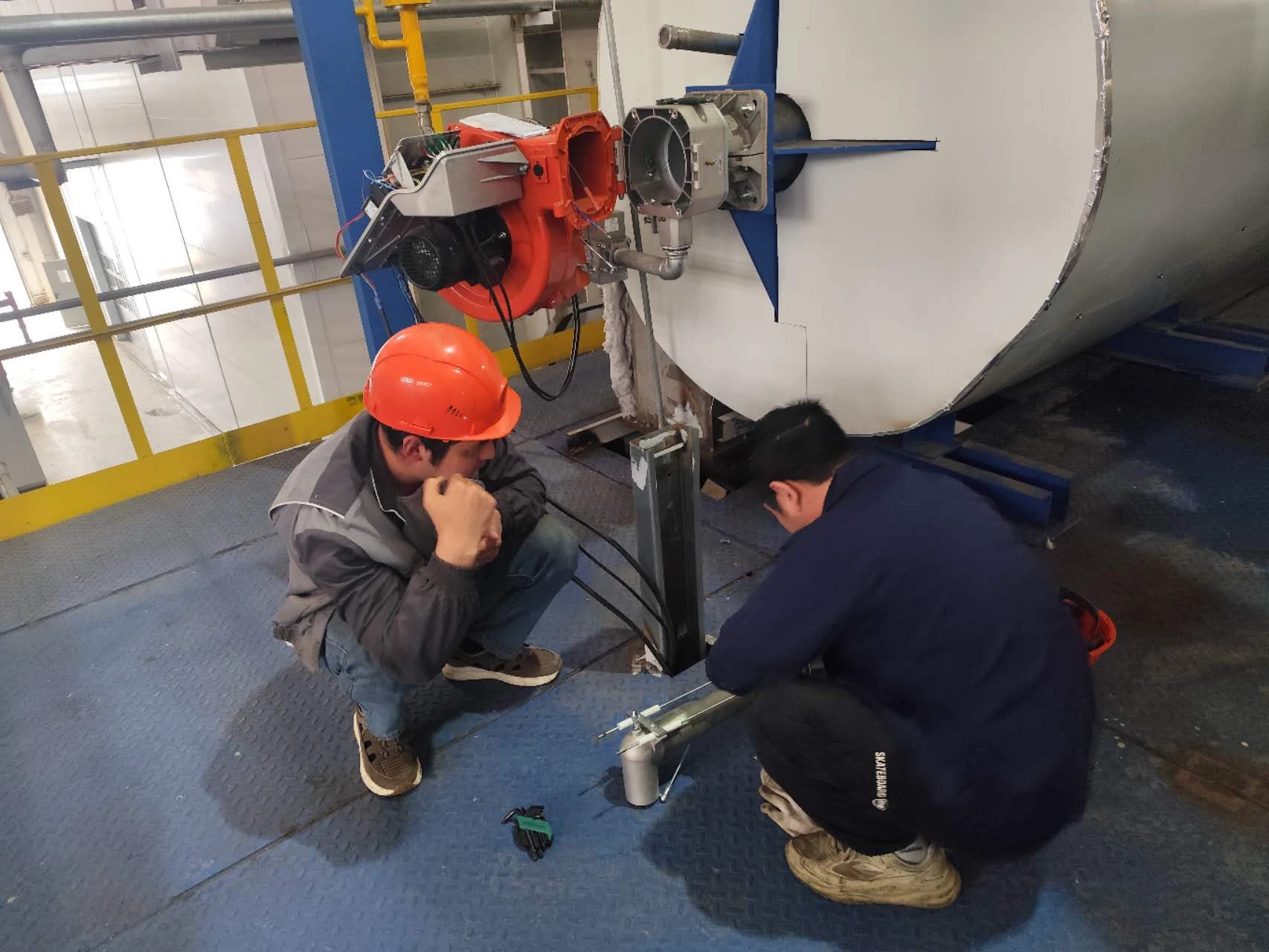

Engineers performing burner installation work and ignition assembly training at the project site
On-site installation support and practical training for ignition-assembly removal and reinstallation.

6. Remote Signal Integration and Relay-Circuit Modification

The burner control system integration work connected the burner package with the plant’s remote control functions. Start, stop, alarm reset, and temperature-setting signals were checked. The air-pressure-switch circuit was also modified by changing to a relay arrangement so the field logic could operate as required.

This part of commissioning demonstrates why controls cannot be treated as an accessory to the burner. The burner sequence, protective devices, plant commands, and temperature controller must exchange signals correctly before the system can be handed over for routine operation. Heatflam supports this type of burner-system integration and customized industrial combustion solution for site-specific process requirements.

What Problems Were Solved During Commissioning?

The commissioning team did more than confirm that power was available and the burners could start. The site work addressed four practical integration risks:

  • Connection accuracy: field wiring and cable numbers were verified before functional testing.
  • Unstable or unsuitable staged settings: ignition and high-fire positions were adjusted under real operating conditions.
  • Abnormal operating noise: the symptom was investigated during burner adjustment and site operation.
  • Control-interface mismatch: remote commands were integrated and the air-pressure-switch circuit was adapted with a relay.

These tasks were connected. A wiring issue can look like a burner fault; an incorrect staged position can affect temperature response; and a local burner that operates normally may still fail the plant’s remote-control sequence. Effective Baltur burner commissioning therefore requires checks at equipment, combustion, electrical, and plant-control levels.

How Was the Rock Wool Plant Burner System Tested?

The test plan was based on repeatability and functional response rather than a single start-up demonstration. The on-site verification included:

  1. Repeated start-stop testing to observe whether ignition remained stable over multiple cycles.
  2. Low-fire temperature-control observation to check stable control and confirm that the process did not exceed the target temperature.
  3. High-fire operating verification to determine whether the system could reach the required set temperature.
  4. Remote function checks for start, stop, alarm reset, and temperature-setting signals.
  5. On-site combustion testing with an analyzer display used to observe operating parameters under actual conditions.
Combustion analyzer display used during on-site high-fire burner testing
Combustion analyzer display observed during on-site high-fire testing.

Final Commissioning Results

The completed tests produced the following observed results for the installed system:

  • Stable ignition after repeated start-stop tests.
  • Stable low-fire temperature control without overshoot.
  • High-fire operation reached the required set temperature.
  • Remote start, stop, alarm-reset, and temperature-setting signals operated normally.

Together, these results confirmed that the burner package, staged settings, temperature-control response, and remote interface were functioning as required at the time of on-site testing. Operator training also formed part of the handover, helping the site team understand the ignition-assembly service procedure.

What This Project Shows About Industrial Burner Commissioning

A reliable commissioning process follows the signal path from the plant control system to the burner and then confirms the resulting process response. For this Moscow rock wool project, the work combined physical installation checks, burner adjustment, troubleshooting, operator training, relay logic, and functional testing.

For future projects, buyers should define the fuel, required heat output, process temperature, furnace or hot-air-system interface, available gas pressure, electrical supply, control signals, applicable local requirements, installation space, and test acceptance criteria before equipment selection. These inputs help the burner supplier and site team plan the correct hardware, control architecture, and commissioning sequence.

A Practical Commissioning Checklist for Similar Burner Systems

The following sequence can help a plant team organize a similar commissioning job. It is general engineering guidance, not a substitute for the burner manufacturer’s instructions, the approved electrical drawings, or site-specific safety procedures.

  1. Confirm the design basis: burner model, fuel, required output, furnace interface, supply pressure, voltage, control philosophy, and acceptance criteria.
  2. Complete cold checks: verify wiring numbers, terminals, grounding, rotation where applicable, valves, pressure switches, ignition components, and mechanical installation before introducing fuel.
  3. Verify permissives and interlocks: confirm that the burner can start only when the required plant and burner conditions are satisfied.
  4. Establish ignition: observe the complete start sequence and adjust the ignition position using the approved procedure and instruments.
  5. Check low-fire control: observe temperature response, flame stability, and whether the process approaches the setpoint without unacceptable overshoot.
  6. Set and verify high fire: confirm the staged transition and verify that the process can reach the required operating condition without abnormal noise or unstable operation.
  7. Test plant controls: check remote start, stop, reset, setpoint, status, and alarm functions one by one against the I/O list.
  8. Prove repeatability: run repeated start-stop cycles and record the result instead of accepting one successful start.
  9. Document and hand over: record final settings, unresolved limitations, test conditions, alarm behavior, and operator-maintenance procedures.

If a Burner Shows Similar Symptoms, What Should Be Checked?

A symptom does not identify one universal cause. The table below gives practical starting points for a qualified commissioning team. Testing must follow the approved manual, drawings, lockout procedures, and site safety rules.

Observed Symptom Useful Checks Evidence to Record
Ignition is inconsistent Start-sequence status, ignition-assembly condition and position, flame-detection signal, fuel and air conditions, and interlock state Cycle count, failure point, alarm code, operating conditions, and corrective action
Abnormal noise appears during operation Operating stage, burner and duct mounting, fan or airflow condition, combustion-head setting, fuel-supply condition, and furnace response When the noise begins, load stage, relevant settings, and whether the symptom changes after adjustment
Temperature overshoots at low fire Low-fire setting, temperature-sensor location and signal, controller parameters, process delay, and burner staging logic Setpoint, temperature trend, stage command, sensor reading, and time response
Remote command does not operate correctly I/O mapping, voltage and common reference, relay logic, command duration, permissive state, alarm-reset conditions, and local/remote selection Command at the plant controller, signal at the burner terminal, resulting burner status, and any active interlock

Frequently Asked Questions

Q1: What is included in industrial burner commissioning?
A1: The exact scope depends on the installation. This project included field-wiring checks, start-up, ignition and high-fire adjustment, operating-noise troubleshooting, remote-signal integration, a relay-circuit modification, repeated operating tests, and operator training.
Q2: Why are repeated start-stop tests necessary?
A2: A single successful ignition does not demonstrate repeatability. Repeated cycles help the commissioning team observe whether the ignition setting, field signals, and burner sequence continue to operate consistently.
Q3: What remote signals were verified in this project?
A3: The site tests checked remote start, remote stop, alarm reset, and temperature-setting signals. These functions operated normally after integration.
Q4: What was checked during on-site combustion testing?
A4: The commissioning team observed analyzer values together with ignition stability, low-fire temperature response, the transition to high fire, and operation at the required set temperature. Evaluating these items together helps connect burner settings with actual process response.
Q5: What information should be provided for a burner installation and commissioning enquiry?
A5: Provide the fuel type, required heat output, process temperature, furnace or heater details, gas pressure, voltage and frequency, installation drawings, available space, control signals, operating sequence, site conditions, and applicable codes or acceptance criteria.
Planning an Industrial Burner Project?

Send Heatflam your fuel type, heat output, process temperature, gas pressure, electrical supply, application details, installation drawings, control requirements, site conditions, and test criteria. Our engineers can review the burner selection, integration scope, and commissioning plan.
