Blogs

Industrial Burner Commissioning for a Rock Wool Plant in Moscow

August 6, 2026
By kenny
29 min read
kenny
kenny

Kenny, a Shanghai Yankong expert, delivers turnkey combustion solutions globally, bridging the gap between engineering and operations to maximize safety and ROI for industrial clients.

Article Cover
TL;DR: HEATFLAM completed the installation and commissioning of five Baltur burners for a rock wool production plant in Moscow. The field scope covered wiring verification, ignition and high-fire settings, operating-noise troubleshooting, ignition-assembly training, remote signal integration, and a pressure-switch relay modification. Repeated tests confirmed stable ignition, controlled low-fire operation without observed temperature overshoot, high-fire operation reaching the required setpoint, and normal remote-control signals.

Industrial burner commissioning is the point at which individual components must operate as one coordinated process system. At this rock wool plant in Moscow, the work involved four Baltur TBG 80 LX P burners and one Baltur TBG 200 burner. The assignment was not limited to starting the burners: it connected field wiring, burner settings, control commands, furnace response, and operator understanding.

This case explains the completed burner installation and commissioning scope, the on-site issues addressed, and the operating checks used before handover. It also shows why a rock wool plant burner system should be verified at both equipment and production-line levels.

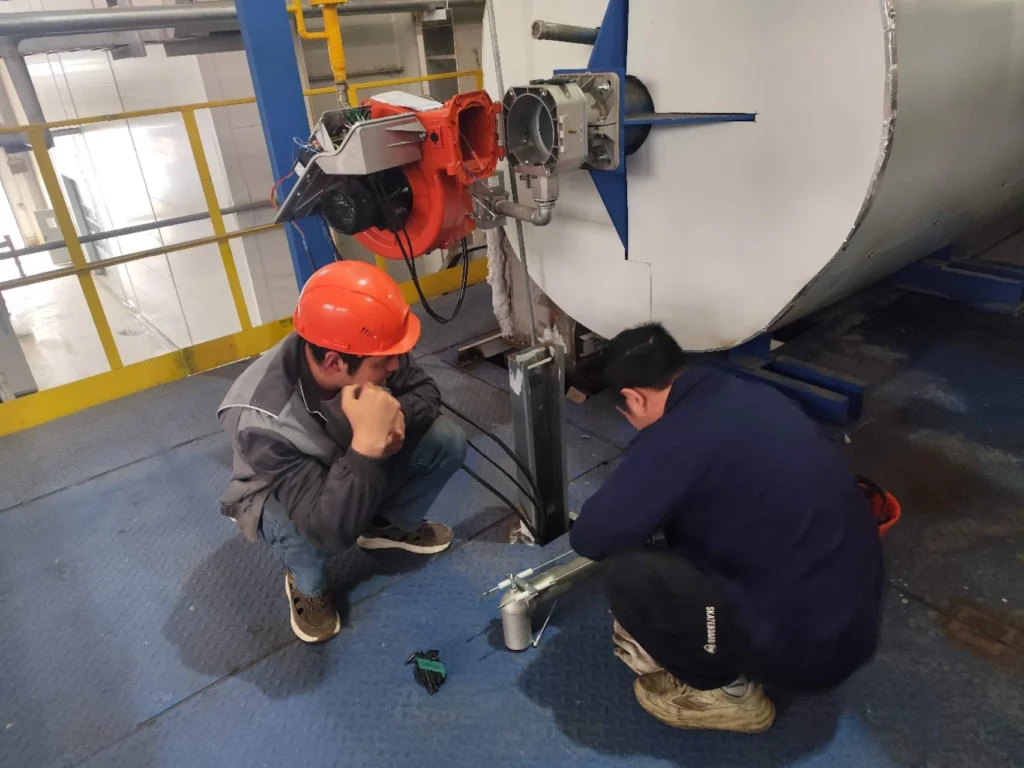

Completed burner system and production-line inspection at the rock wool plant in Moscow.

Project Overview

Project Item Confirmed Scope
Location Moscow, Russia
Industry Rock wool production
Burner configuration 4 × Baltur TBG 80 LX P; 1 × Baltur TBG 200
Engineering scope Installation checks, startup settings, troubleshooting, training, relay modification, control integration, and functional testing
Verified outcome Stable repeated ignition, stable low-fire temperature control, high-fire setpoint achieved, and remote signals functioning normally

The models are identified here only as the equipment installed in this project. Selection for another furnace requires confirmation of the process duty, fuel, required heat output, furnace pressure, electrical supply, control method, installation geometry, and local requirements.

From Burner Installation to System Commissioning

A burner can be mechanically installed while the wider industrial combustion system is still not ready for production. Commissioning closes that gap. For this project, the burners, field terminals, temperature controls, interlocks, remote commands, and hot-air furnace interfaces had to be checked as connected parts of the same operating sequence.

The work began with wire-number verification. Each field connection was checked against its intended signal so that commands and feedback could be traced before repeated startup tests. This reduced uncertainty when diagnosing later behavior: a burner response could be evaluated against a known wiring condition instead of an assumed one.

The startup sequence then moved to ignition-position setup and high-fire-position setting. These adjustments were completed on the installed equipment under site conditions. The objective was to establish reliable ignition, controlled low-fire operation, and sufficient high-fire output for the process to reach its required temperature setpoint.

Completed Commissioning Scope

  • Field wiring verification: checked on-site connections and wire numbers before functional testing.
  • Ignition-position setup: established the burner position used during the ignition sequence.
  • High-fire-position setting: adjusted high-fire operation for the installed furnace and required process setpoint.
  • Industrial burner troubleshooting: investigated and resolved abnormal noise observed during operation.
  • On-site training: demonstrated removal and reinstallation of the ignition assembly for the plant team.
  • Remote burner control integration: connected and checked remote start/stop, alarm reset, and temperature-setpoint signals.
  • Pressure-switch relay modification: changed the relay arrangement associated with the air-pressure switch to meet the required control logic.
Engineering note: Burner settings and safety-related control changes must be established and tested for the actual furnace, fuel supply, process duty, interlock chain, and site rules. Settings from this case should not be copied to another installation.

Burner Control System Integration

For a production plant, local burner operation is only one layer of acceptance. The burner control system integration also has to exchange the correct commands and status signals with the wider plant control architecture. In Moscow, the team connected the remote interface and verified three functions: start/stop commands, alarm-reset commands, and the temperature-setpoint signal.

These checks were performed as functional tests, not as visual confirmation at the terminals. A command had to create the intended response, and the burner system had to remain stable while moving through the required operating states. This system-level approach is central to customized combustion-system integration, particularly when several burners serve connected sections of a production line.

Troubleshooting Under Operating Conditions

An abnormal operating sound was identified during the startup work. Rather than treating it as an isolated noise issue, the commissioning process considered it alongside burner position, mechanical installation, airflow-related behavior, and the surrounding furnace interface. The issue was resolved before the final repeated-start tests.

The pressure-switch relay change was also completed as part of the control-side correction. After modification, the relevant sequence and remote functions were tested again. This is an important distinction in industrial burner troubleshooting: a component change is not the end of the task. The complete operating sequence must be rechecked after the change.

Verified Test Results

Final acceptance focused on repeatable behavior rather than a single successful start. The completed Baltur burner commissioning work produced the following observed results:

  • Ignition remained stable through repeated start-stop testing.
  • Low-fire temperature control remained stable, with no observed temperature overshoot.
  • High-fire operation raised the process to the required temperature setpoint.
  • Remote start/stop, alarm reset, and temperature-setpoint signals functioned normally.

These results describe the tests completed at this site. They are not general performance guarantees for other furnaces or operating conditions.

What This Case Shows

For a multi-burner rock wool production line, commissioning is most useful when it follows the actual signal and energy path: confirm wiring, establish ignition, verify low-fire control, set high-fire operation, resolve abnormal behavior, integrate remote commands, and repeat the full sequence. That sequence links each hot air furnace burner to the production requirement it serves.

The Moscow project also demonstrates the value of including operator training in the handover. Showing the plant team how to remove and reinstall the ignition assembly gave them a practical reference for future inspection work without representing training as a substitute for qualified burner service.

Frequently Asked Questions

Q1: What is included in industrial burner commissioning?
A1: The exact scope depends on the installation. In this case it included wiring verification, ignition and high-fire settings, operating-noise troubleshooting, ignition-assembly training, remote signal integration, a pressure-switch relay modification, and repeated functional tests.
Q2: Why verify remote signals during commissioning?
A2: Remote commands connect the burner package to the plant control system. Testing start/stop, alarm reset, and temperature-setpoint signals confirms that the intended command produces the intended equipment response.
Q3: How was stable ignition checked in this project?
A3: The system was started and stopped repeatedly after setup and troubleshooting. Ignition remained stable throughout those repeated tests.
Q4: Can the same burner settings be used on another rock wool plant?
A4: No setting should be transferred without engineering verification. Furnace geometry, process duty, fuel conditions, pressure, control logic, electrical supply, and required heat output must be confirmed for each installation.
Planning a Burner Installation or Commissioning Project?

Send the application, fuel, required heat output, furnace pressure, electrical supply, control signals, installation drawings, site location, and project schedule. HEATFLAM can review the burner, controls, interfaces, and commissioning scope as one engineering package.

Request a Proposal

Baltur is referenced solely to identify the equipment used in this project. No affiliation or authorization is implied.
